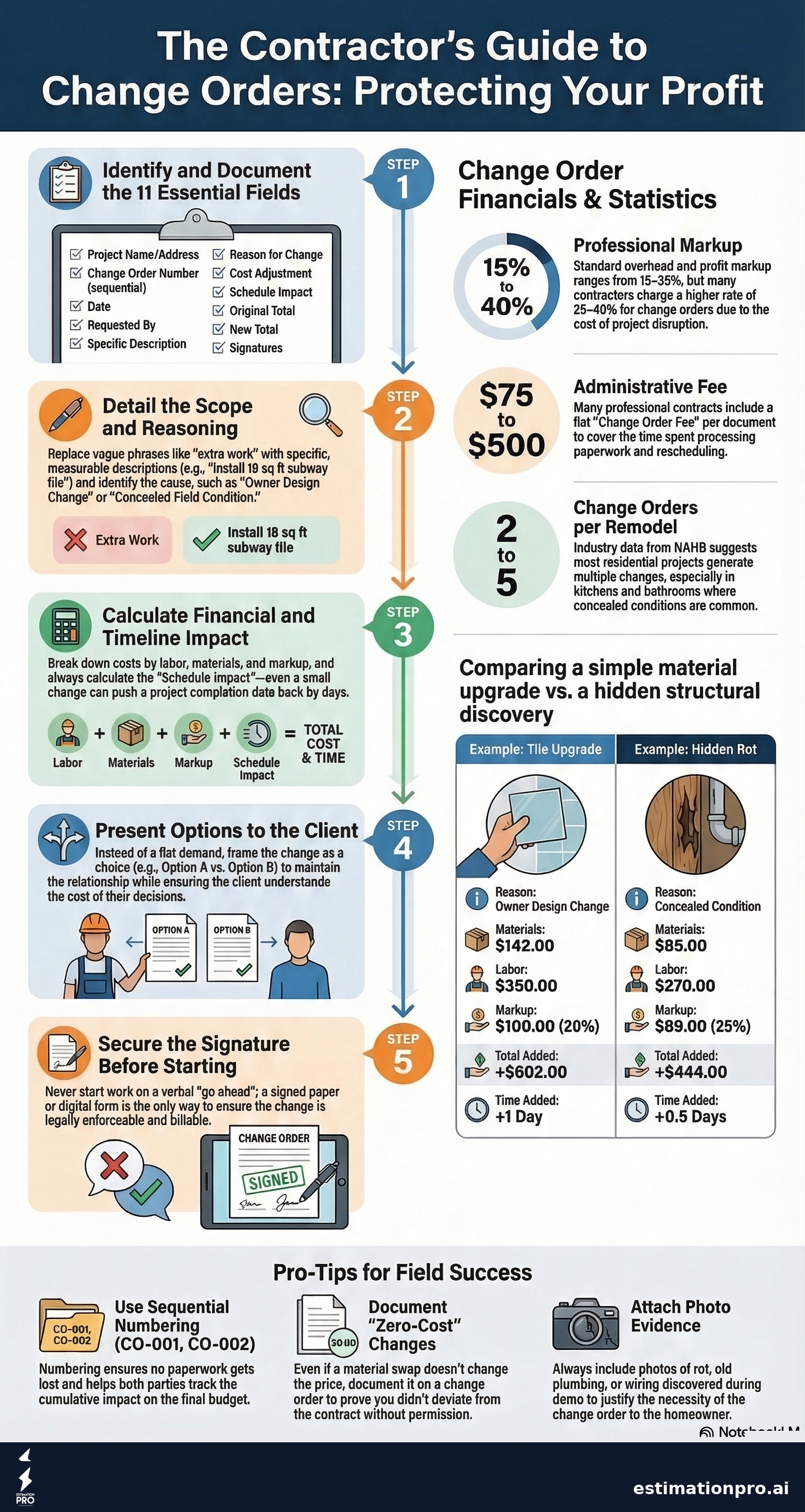

Here’s a free construction change order template you can copy or print, plus two filled-out examples with every number worked out. I’ve been burned by underbidding jobs where the hidden scope blew up once the walls came open. Rot, old wiring, plumbing that wasn’t up to code. A signed change order is how you get paid for that work instead of eating it.
Quick Answer
A construction change order is a one-page form that records a change to the original contract: what changed, why, what it costs, how many days it adds, the new contract total, and both signatures. Copy the blank form below, fill it in on site, and get it signed before the extra work starts. To fill one in and print or save a PDF, use the free Change Order Template tool. To send the estimate and, on the Pro plan, the change orders and the invoice from one place: Try EstimationPro
The Blank Change Order Form (Copy This)
Print it, paste it into your own letterhead, or copy it into a spreadsheet. Every blank is something you will need if the change is ever disputed.
CHANGE ORDER No. CO-____
| Field | Fill in |
|---|---|
| Contractor (name, license no., phone) | ______________________ |
| Client (name, phone, email) | ______________________ |
| Project name and address | ______________________ |
| Original contract date | ____ / ____ / ______ |
| Date of this change order | ____ / ____ / ______ |
| Requested by | ☐ Client ☐ Contractor (field condition) ☐ Inspector or code ☐ Designer |
| Type of change | ☐ Add work ☐ Remove work (credit) ☐ Substitute material ☐ Schedule only |
| Description of change (what, where, how much) | ______________________ |
| Reason for change | ______________________ |
| Pricing method | ☐ Lump sum ☐ Unit price ☐ Time and materials, not to exceed $______ |
Cost breakdown
| Item | Qty | Unit | Unit cost | Total |
|---|---|---|---|---|
| Materials | ____ | ____ | $____ | $____ |
| Labor | ____ | hrs | $____ | $____ |
| Subcontractor | ____ | ____ | $____ | $____ |
| Equipment, disposal, permit | ____ | ____ | $____ | $____ |
| Subtotal | $____ | |||
| Overhead and profit (____%) | $____ | |||
| Change order total (use a minus sign for a credit) | $____ |
Contract and schedule
| Original contract price | $______ |
| Previous approved change orders (net) | $______ |
| This change order | $______ |
| New contract price | $______ |
| Days added (or removed) | ____ |
| New completion date | ____ / ____ / ______ |
| Payment schedule change | ______________________ |
Approval
Work described above will not start until this change order is signed by both parties. All other terms of the original contract stay the same.
Contractor signature: ________________ Date: ________
Client signature: ________________ Date: ________
Attachments: ☐ Photos ☐ Drawings or sketch ☐ Product spec sheet
That’s it. One page. The “previous approved change orders” line is the one that stops the “how did we get to this number?” conversation at the final invoice.
Filled-Out Example 1: Kitchen Backsplash Added Mid-Job
The client’s original scope had painted drywall behind the range. Halfway through the job she decided she wanted subway tile.
CO-003, Johnson Kitchen Remodel, 1847 Cedar St
| Field | Entry |
|---|---|
| Date | October 6, 2026 |
| Requested by | Client (Sarah Johnson) |
| Type | Add work |
| Description | Install 18 sq ft of 3x6 ceramic subway tile backsplash on the wall behind the range, from countertop to hood, set in thinset on the existing drywall (taped, not yet primed or painted) and grouted. Tile selected by client. |
| Reason | Client design change |
| Pricing method | Lump sum |
| Item | Qty | Unit | Unit cost | Total |
|---|---|---|---|---|
| Subway tile (18 sq ft + 10% waste, rounded up) | 20 | sq ft | $4.00 | $80 |
| Thinset mortar, 50 lb | 1 | bag | $20.00 | $20 |
| Grout, 25 lb | 1 | bag | $20.00 | $20 |
| Tile labor (layout, set, grout, clean) | 3 | hrs | $90.00 | $270 |
| Subtotal | $390 | |||
| Overhead and profit (20%) | $78 | |||
| Change order total | $468 |
| Original contract price | $47,200 |
| Previous approved change orders | +$650 |
| This change order | +$468 |
| New contract price | $48,318 |
| Days added | 1 |
Check the math: $80 + $20 + $20 + $270 = $390. 20% of $390 is $78. $390 + $78 = $468. $47,200 + $650 + $468 = $48,318. That works out to about $26 per square foot installed, which is in the normal range for a small subway backsplash. Small areas run high per square foot because the layout and cleanup take the same time whether it’s 18 square feet or 40.
Notice the description. “18 sq ft of 3x6 subway, countertop to hood, on existing drywall” can be checked against the wall. “Add backsplash” can’t.
Filled-Out Example 2: Rotted Subfloor Found at Demo
Not every change order starts with the client. In the Pacific Northwest, moisture is the number one enemy, and water damage behind walls and under fixtures is everywhere in older homes. You open up a bathroom expecting a simple remodel and find rot that changes the scope.
CO-001, Martinez Bathroom Remodel, 922 Elm Ave
| Field | Entry |
|---|---|
| Date | October 13, 2026 |
| Requested by | Contractor (field condition) |
| Type | Add work |
| Description | Demo exposed water damage and soft, rotted plywood subfloor around the tub drain and toilet flange. Remove and replace 60 sq ft of 3/4” plywood subfloor, glued and screwed to joists. Photos 1-4 attached. |
| Reason | Concealed condition, not visible until the finished floor was removed |
| Pricing method | Unit price for subfloor (overhead and profit included in the rate). Joist repair, if any, on a separate change order |
| Item | Qty | Unit | Unit cost | Total |
|---|---|---|---|---|
| Subfloor replacement: cut out rotted plywood, haul off, install 3/4” plywood glued and screwed | 60 | sq ft | $6.00 | $360 |
| Change order total | $360 |
| Original contract price | $22,500 |
| Previous approved change orders | $0 |
| This change order | +$360 |
| New contract price | $22,860 |
| Days added | 0.5 |
Check the math: 60 sq ft x $6.00 = $360. $22,500 + $360 = $22,860. Subfloor replacement commonly runs about $2 to $8 per square foot installed, and rot around a tub drain and toilet flange is slower work than an open floor, so this one is priced toward the high side. Because it’s a unit price, the $6.00 already carries overhead and profit. Don’t add a markup line on top of a unit price, or you’ve charged it twice.
Two things make this one hold up. First, the description says what was found and why nobody could see it before demo. Second, it limits the price to the subfloor. If the joists under it are bad too, that’s a new change order with its own photos, not a blank check. When you truly can’t see the extent yet, price it as time and materials with a not-to-exceed number, so the client knows the most it can cost.
How to Price the Change Before You Fill In the Form
The form is only as good as the number on it. Price a change the same way you priced the original job, line by line:
- Materials with waste. Measure, add your waste factor, and round up to full boxes or sheets you can actually buy.
- Labor in hours. Hours times your billing rate, not your wage. Small changes take longer per unit because setup and cleanup don’t shrink.
- Subs, disposal, permits. If the change needs a sub, a dumpster run or a revised permit, it goes on the form.
- Overhead and profit. Change orders should carry the same overhead and profit you built into the original contract. Most remodelers land somewhere between 15% and 35%. Whatever your rate is, write it into the original contract so nobody is surprised by it.
- Schedule. Days added belong on the form even when the price is $0.
There are three common ways to price it: a lump sum (one price for the change), unit price (per square foot, per fixture), or time and materials. Use time and materials when you can’t see the full extent yet, and always give it a not-to-exceed cap.
For the bigger picture on types of change orders and when to use one, see the construction change order guide. For the full pricing walkthrough with more examples, read how to price a change order. If you want a separate admin charge for writing them up, see change order fees. To check that your markup actually covers your overhead, run it through the contractor markup calculator.
The Five Mistakes That Make a Change Order Worthless
1. Starting before the signature. This is the big one. The client says “yeah, go ahead,” you pick up the hammer, and at invoice time they don’t remember agreeing to the cost. Get the signature first, even if it holds up the crew for a day.
2. A vague description. “Extra work per client request” tells nobody anything. If you wouldn’t accept that line on a sub’s invoice, don’t put it on your own form.
3. No numbering. With four change orders and no numbers, nobody knows which were approved and which are still pending. CO-001, CO-002, and so on. On bigger jobs, track them in a change order log.
4. No schedule impact. A change that adds a week and doesn’t say so is how you get blamed for finishing “late” on the original date.
5. No running total. By the third change, clients lose track of how much the job has grown. Show the original price, the previous changes and the new total on every form.
Do You Need the AIA G701 Change Order Form?
Usually not, on a residential remodel. The AIA G701 is the American Institute of Architects’ standard change order. It’s built for jobs with an architect, who signs it along with the owner and the contractor. According to AIA’s own summary, signing it means everyone agrees to the change, including any change to the contract sum and the contract time. AIA documents are copyrighted and sold through AIA Contract Documents as a one-time license or a subscription, so a free “AIA” download is not the licensed form.
If your contract is an AIA contract, use the G701, because that’s what the contract calls for. If you’re a remodeler working directly for a homeowner, the one-page form above covers the same ground: description, cost change, time change, signatures. AIA also has a separate form, the G701S, for changes between a contractor and a subcontractor.
What Your Original Contract Should Say
The change order form is only as strong as the contract behind it. Before the job starts, your contract should say:
- All changes are in writing and signed before the work starts. Some states require signed change orders before extra work begins, California for one, so check your state’s contractor licensing board.
- Your overhead and profit rate on changes. State the percentage.
- How concealed conditions are handled. What happens when demo reveals rot, bad wiring or plumbing that isn’t to code.
- Any change order fee. If you charge one, say how much up front.
I walk every new client through the process before we start, and I tell them to hold back 15-20% of their budget for surprises, because there will be surprises. That’s the right moment to explain how change orders work too. Set it up front and the change order conversation becomes routine instead of a fight. It’s also the honest way to bid. A lot of contractors leave scope out on purpose to look cheapest, then make it back on change orders once the kitchen is torn out and the homeowner is stuck. Don’t be that contractor.
Presenting a Change Order Without Souring the Job
Bring it up the day you find it, not at the end. Five change orders dumped on a client at the final walkthrough feels like an ambush, even if every one is fair.
Show them, don’t just tell them. Walk the client over to the rot, or text the photos with the form. Then give options when you honestly have them: the full fix, or a smaller repair that solves the immediate problem, each with its price. People take a change order better when they’re making a decision instead of getting a bill.
Paper or digital doesn’t matter much. A clipboard of blank forms in the truck works fine. So does sending a PDF from your phone. Use whatever gets the signature fastest, and keep a copy either way. A photo of the signed paper form is better than nothing.
FAQ
Do I need a change order for a change with no cost?
Yes. A material swap at the same price still changes the scope. Write it up with a $0 total so both of you have signed off on the new spec. Otherwise the client can later say you didn’t build what the contract says.
Can a client refuse to sign a change order?
Yes, and then you don’t do the extra work. If it’s a concealed condition like rot, explain in writing what happens if it’s left alone and keep a copy. If the work has to start while you’re still agreeing on price, some contracts use a construction change directive, which lets the owner direct the work to start while the price is still being worked out. Only use one if your contract provides for it.
How do I write up a credit when the client removes work?
Use the same form, check “Remove work (credit),” describe exactly what’s coming out, and put the total as a negative number. Some contractors credit only their cost on deleted work, others credit cost plus some of the markup. Pick one and write it into the contract so it isn’t argued job by job. Materials you already bought and can’t return stay on the job, so leave them out of the credit.
How long should I keep signed change orders?
At least as long as you keep the original contract, which is usually 7 to 10 years according to Housecall Pro’s guide. But the time limit for construction claims varies by state, so check yours. Keep a digital copy even if you work on paper.
Should I attach photos?
Every time on a field-condition change order. Once the rot is repaired and the new floor is down, the photos are the only proof it was there. Number them and reference them in the description.
Send It, Get It Signed, Get Paid
The template above and the Change Order Template tool cover most jobs. If you’d rather run the whole job in one place, EstimationPro builds the original estimate from your photos, a voice walkthrough or notes, and contractors save 2+ hours per estimate. On the Pro plan, change orders go to the client as a link they can approve, with e-signatures, invoices and milestone payments in the same place. Estimates you send from EstimationPro also get automatic follow-up reminders, so you’re not chasing a yes. Plans are $79 or $149 a month, or $9 for one estimate. Try EstimationPro on one real job (30-day money-back guarantee)
Sources
Checked October 22, 2026. Change order rules vary by state and by contract; check yours.
- AIA Contract Documents, Summary: G701-2017, Change Order (purpose, signers, contract sum and time): help.aiacontracts.com
- AIA Contract Documents, Instructions: G701S-2017, Change Order (subcontractor change orders): help.aiacontracts.com
- Housecall Pro, Free Change Order Template (overhead and profit on changes, pricing methods, not-to-exceed caps, change directives, record keeping): housecallpro.com
- Loio, Construction Change Order Form Template (form fields, payment schedule changes, state requirements including California): loio.com
- Costs in the worked examples (tile, thinset, grout, tile labor, subway backsplash installed, subfloor replacement installed per sq ft, billing rate, overhead and profit) are within EstimationPro’s 2026 pricing reference. Prices vary by region; get local quotes from your suppliers.
